Construction updates from Market & Johnson…
Work performed in the last 30 days
- Continued Drilling Geothermal Wells
- Completed OH and In-Wall Rough-ins on 1st Floor and 2nd Floor

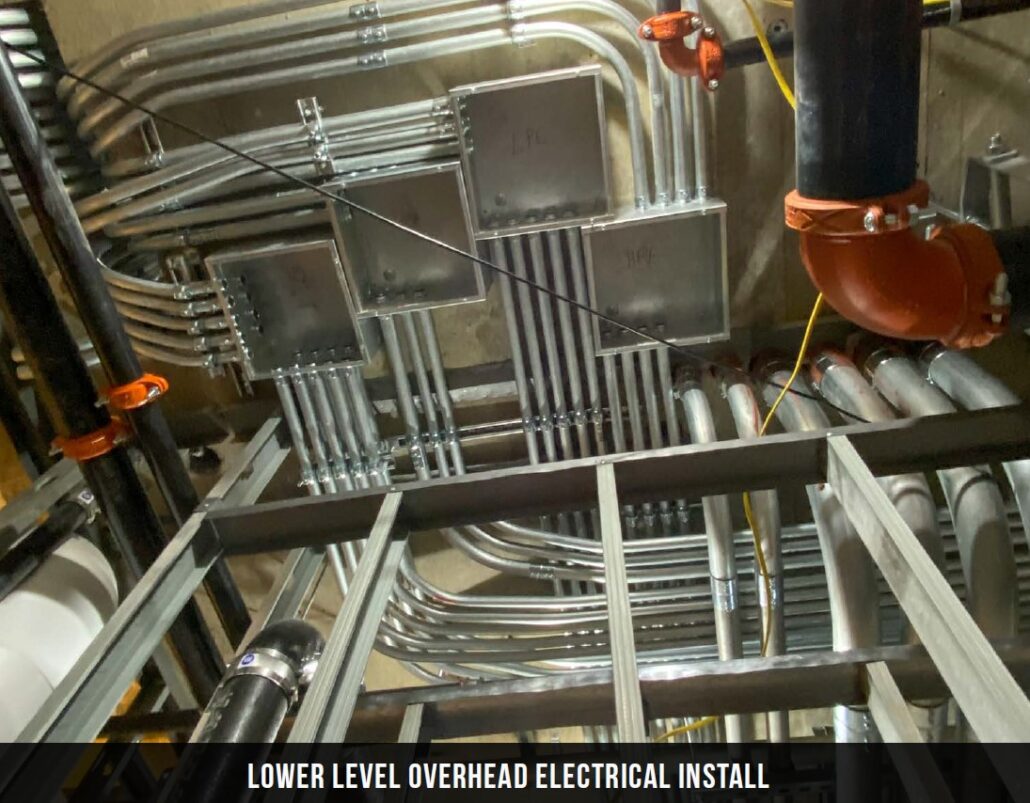

- Continued OH and In-Wall Rough-ins on Lower Level
- Completed Soffit framing 2nd Floor, 1st Floor and Lower level
- Formed & Poured Foundation for Elevator and Lay Back for New Elevator Shaft
- Framed Parapet on Existing Roof
- Re-Roofed Existing 1st and 2nd Floor Roofs
- Installed New Roof on the 3rd Floor Addition

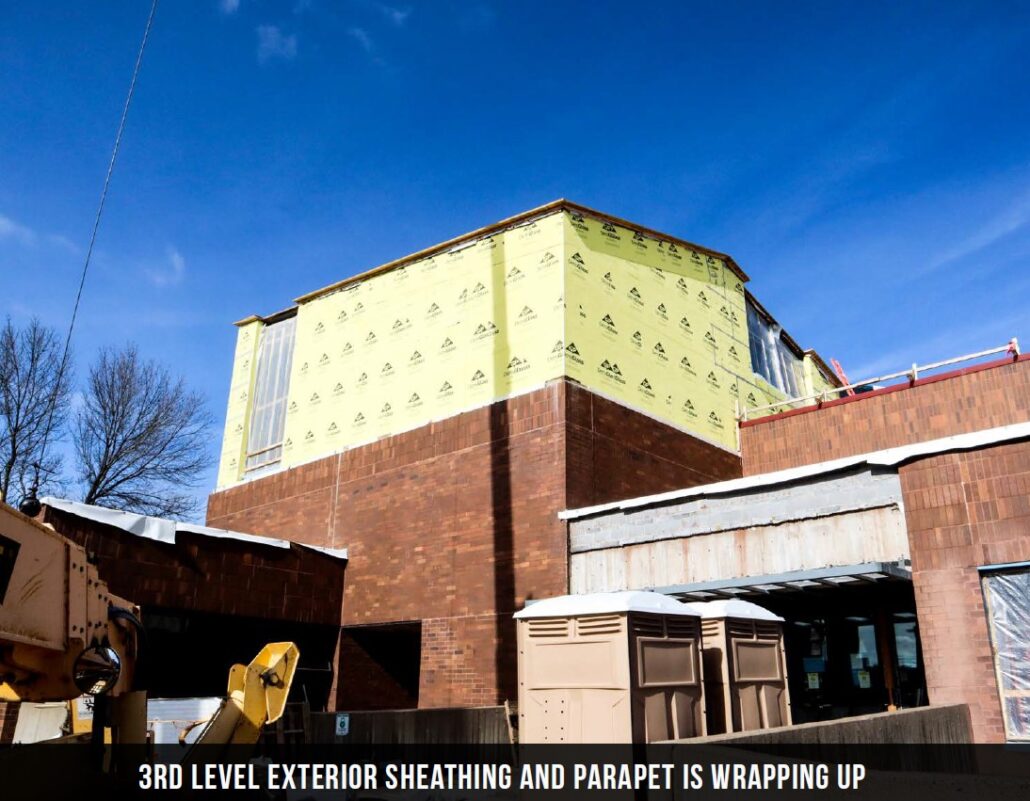

- Framed and Sheet Exterior Walls on 3rd Floor
- Started Setting Overhead Hangers on 3rd Floor

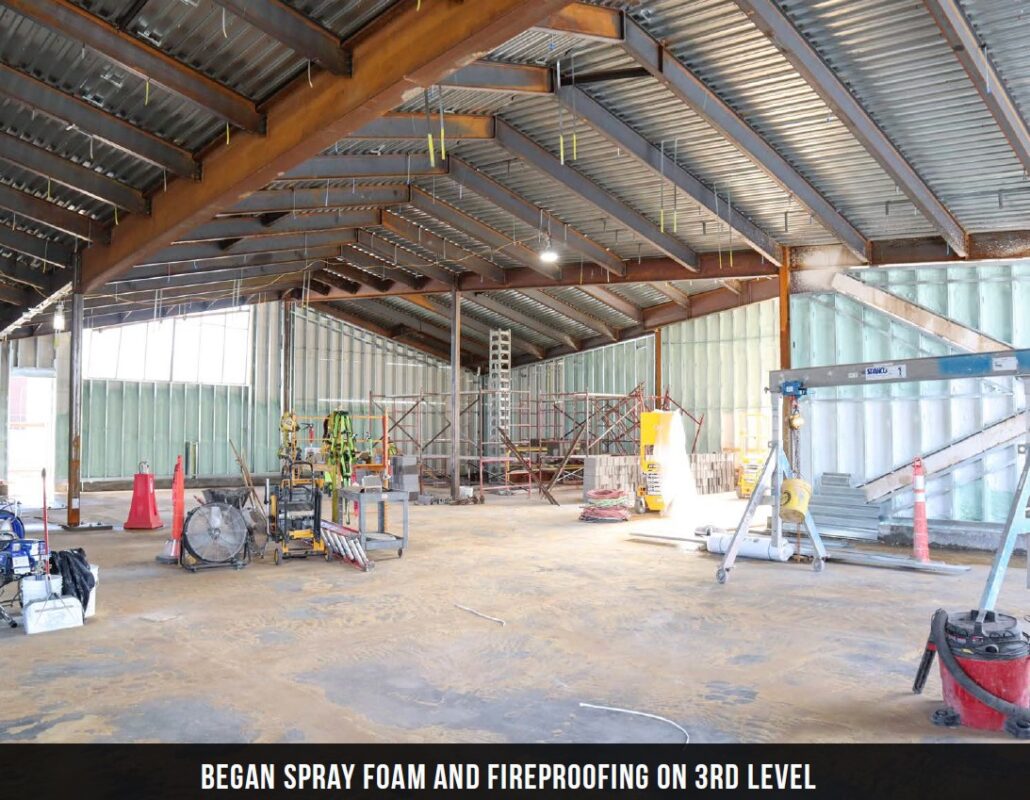

- Completed Fireproof 3rd Floor Addition Steel
- Prepped for Slab Placement at 3rd Floor Addition
Schedule
Geo-Thermal Wells Complete … November 5, 2021

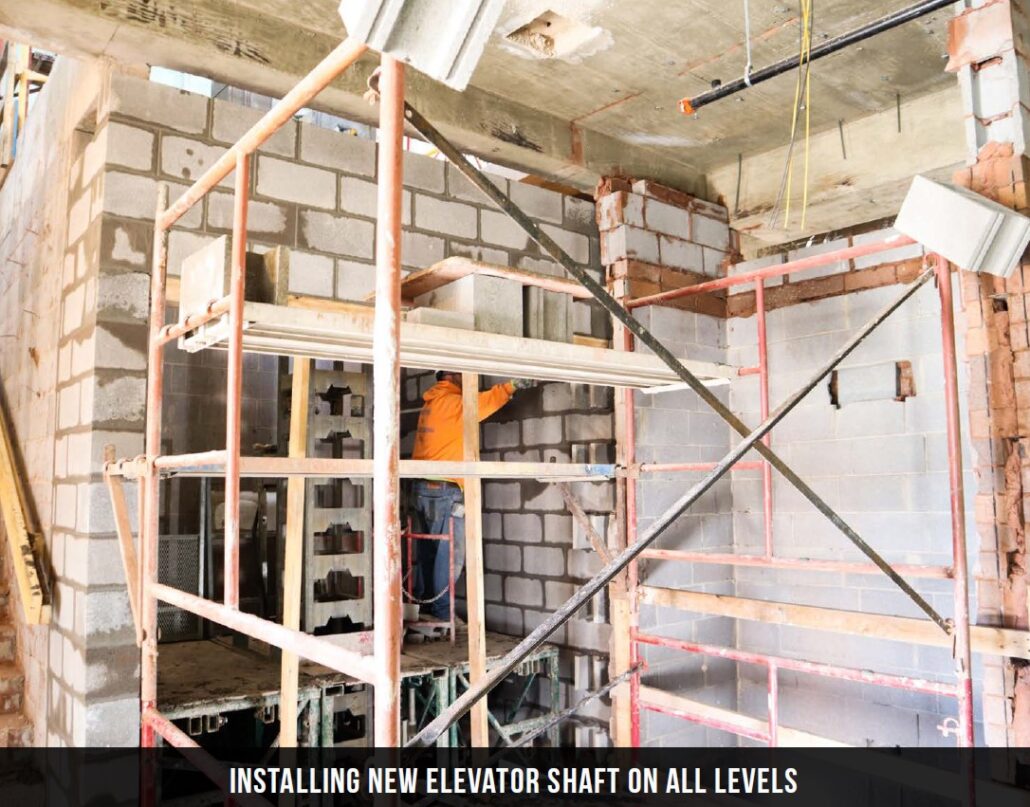

Install New Elevator … December 6, 2021
Building Enclosed … December 31, 2021
Final Occupancy … July 1, 2022
Work scheduled for the next 30 days
- Complete Drilling Geothermal Wells on Eau Claire Street
- Install Geothermal Lines from Geo Wells on Eau Claire Street to the Building
- Install Storm Lines on Eau Claire Street
- Begin Work on US Bank Entry/Exit Drives
- Install 2nd Floor and 1st Floor Door Frames
- Fireproof 3rd Floor Addition
- Pour Slab-on-Grade on 3rd Floor
- Frame Interior Walls on 3rd Floor
- Continue Selective MEP Rough-Ins on All Floors
- Install Both Air Handler Units on 2nd Floor and Lower Level
- Install 1st and 2nd Floor Drywall on Soffits and Tops of Walls
- Install New Electrical and Water Service
