Construction updates from Market & Johnson…
Work performed in the last 30 days
- Completed Drilling Geothermal Wells on Eau Claire Street
- Installed New Water Service to building from Dewey Street
- Installed 1st and 2nd Floor Drywall on Soffits and Tops of Walls
- Continued Selective MEP Rough-Ins on All Floors
- Began installing drywall level 2.
- Began Tape and Finish Level 2

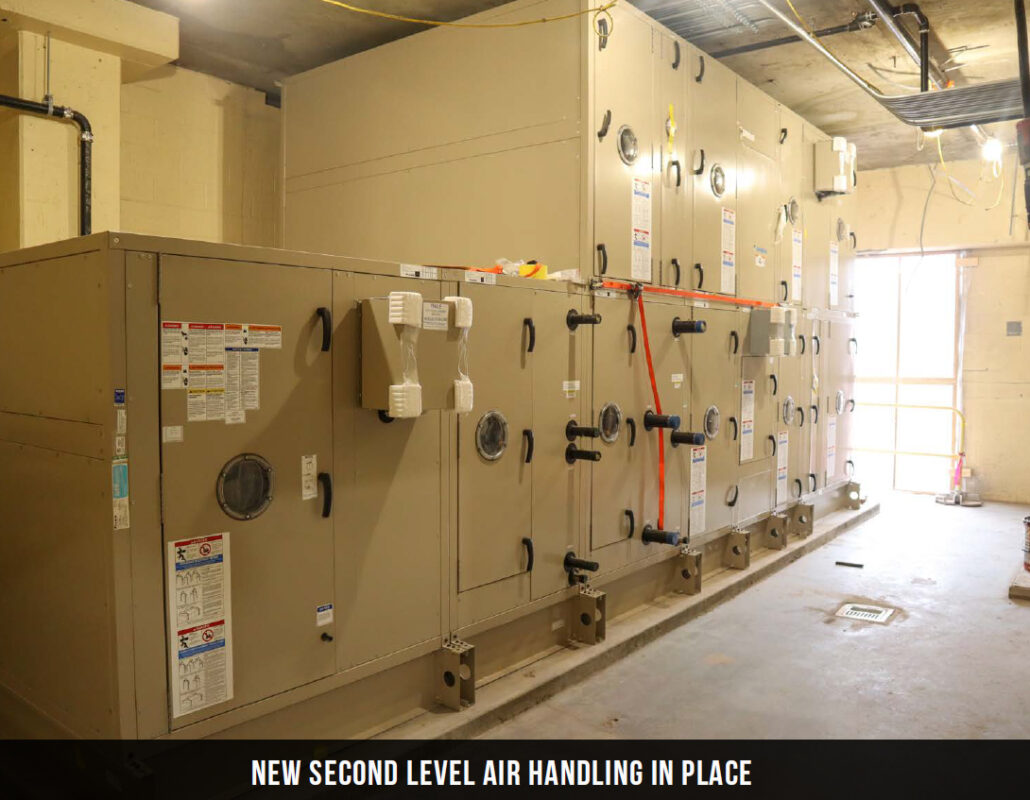

- Installed Air Handler Units on 2nd Floor and Lower Level
- Completed Soffit Framing All Floors

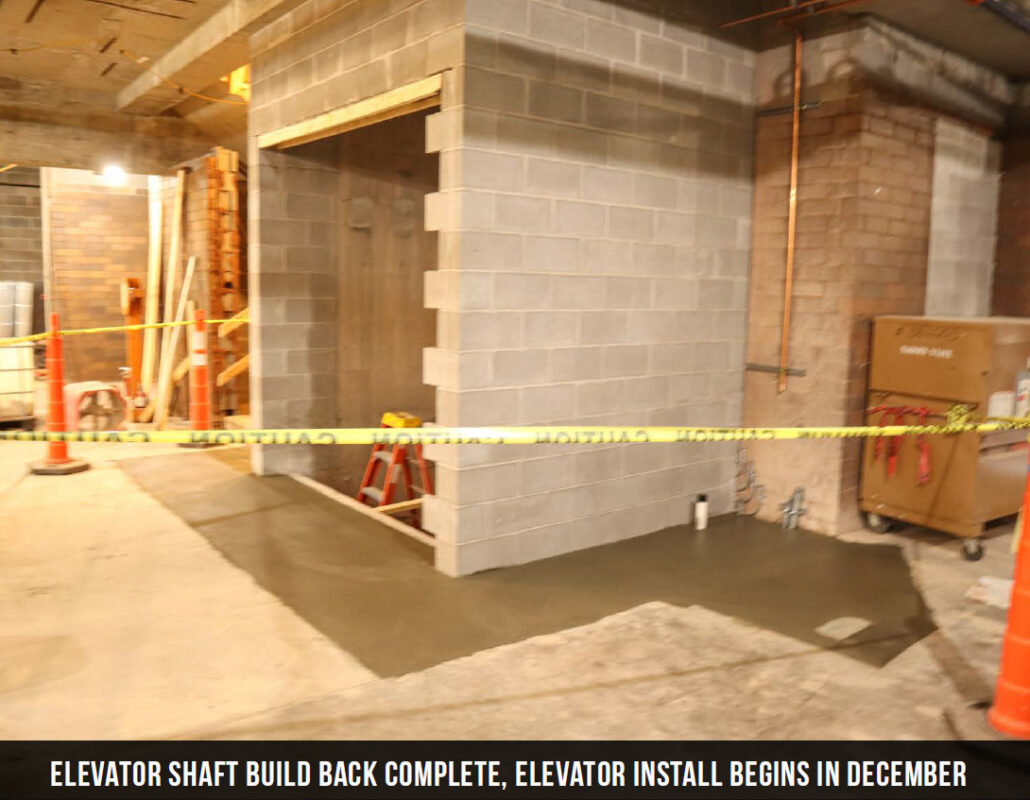

- Completed Masonry Elevator Shaft

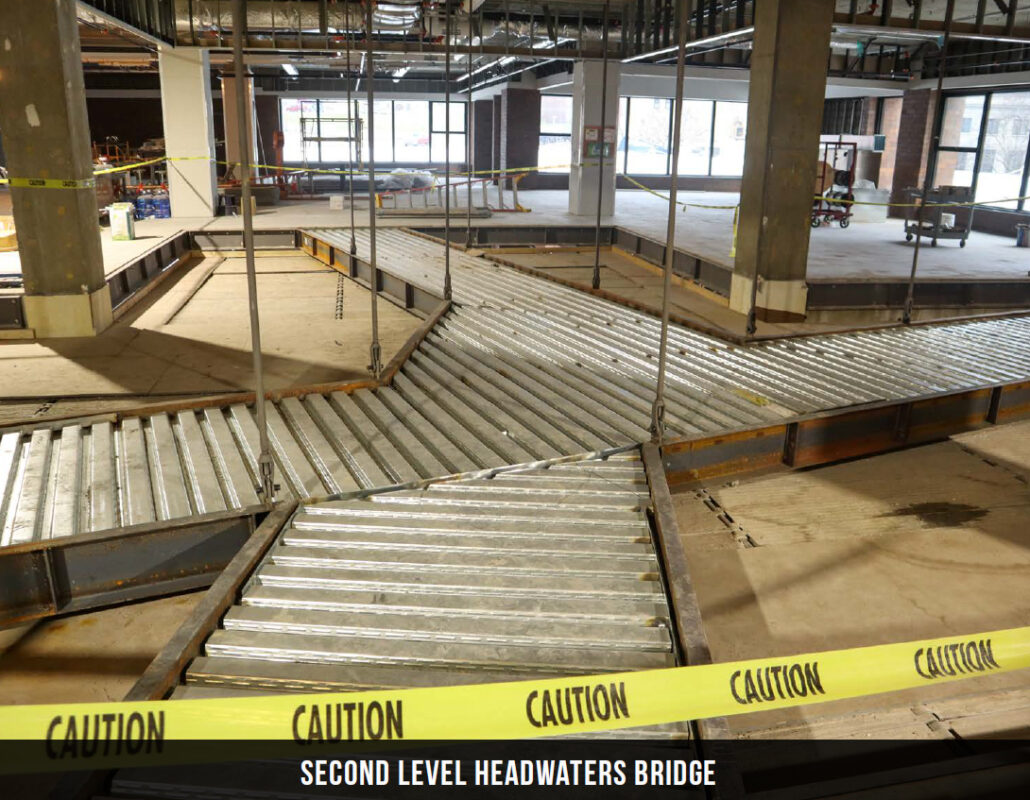

- Installed Headwaters Bridge Steel and Decking
- Received and Installed 2nd Floor and 1st Floor Door Frames
- Fireproofed 3rd Floor Addition
- Poured Slab-on-Grade on 3rd Floor

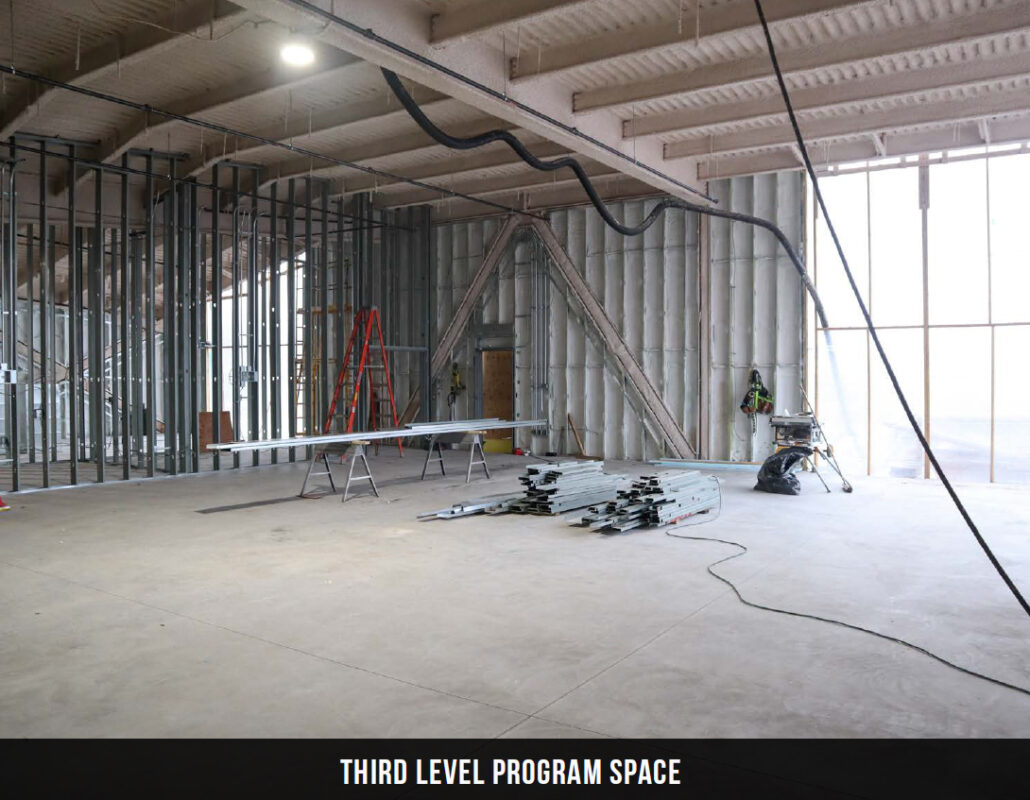

- Installed 3rd Floor Interior Walls
- Began 3rd floor MEPF OH Rough-Ins
Schedule
Begin Elevator Install … December 6, 2021
Building Enclosed … December 31, 2021
Begin Concrete Polishing … January 24, 2022
Final Occupancy … July 1, 2022
Work scheduled for the next 30 days
- Install Geothermal Lines from Geo Wells on Eau Claire Street to the Building
- Install Storm Lines on Eau Claire Street
- Install New Electrical Service and Switch Gear in coordination with Xcel Energy
- Complete Roofing All Levels
- Begin Install Metal Panel System at 3rd Floor Roof
- Complete Selective Overhead/In-Wall MEP Work on All Floors
- Install Drywall Ceilings on All Floors
- Install Drywall on all floors
- Tape, Finish, and Paint 1st and 2nd Floor
- Install New Duct on Lower Level
- Install Drywall Tops and Frame Ceilings on 3rd Floor
- Begin install of New Elevator
- Mock-Up Polished Concrete Floors
- Review Casework/Millwork Shop Drawings
