Construction updates from Market & Johnson…
Work performed in the last 30 days
- Demoed Elevator and Dumb Waiter
- Demo Roof Structures and Roof for Addition
- Complete Lower-Level Demo
- Began X-Ray and Coring PT Slabs

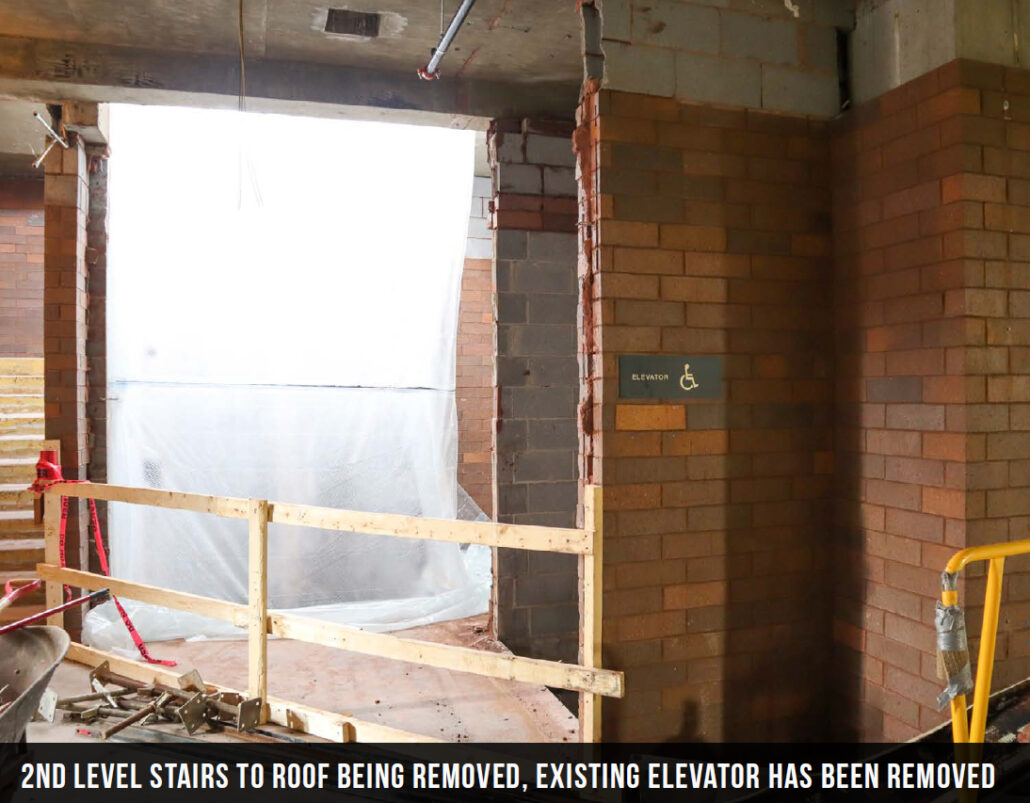

- Demo Elevator Shaft
- Demoed 40 Tons of Metal and 55 Tons of Miscellaneous Demo
- Demoed 130 Tons of Masonry Demo
- Began Site Work and Removals in Eau Claire Street
- Relocate Water and Sanitary to US Bank

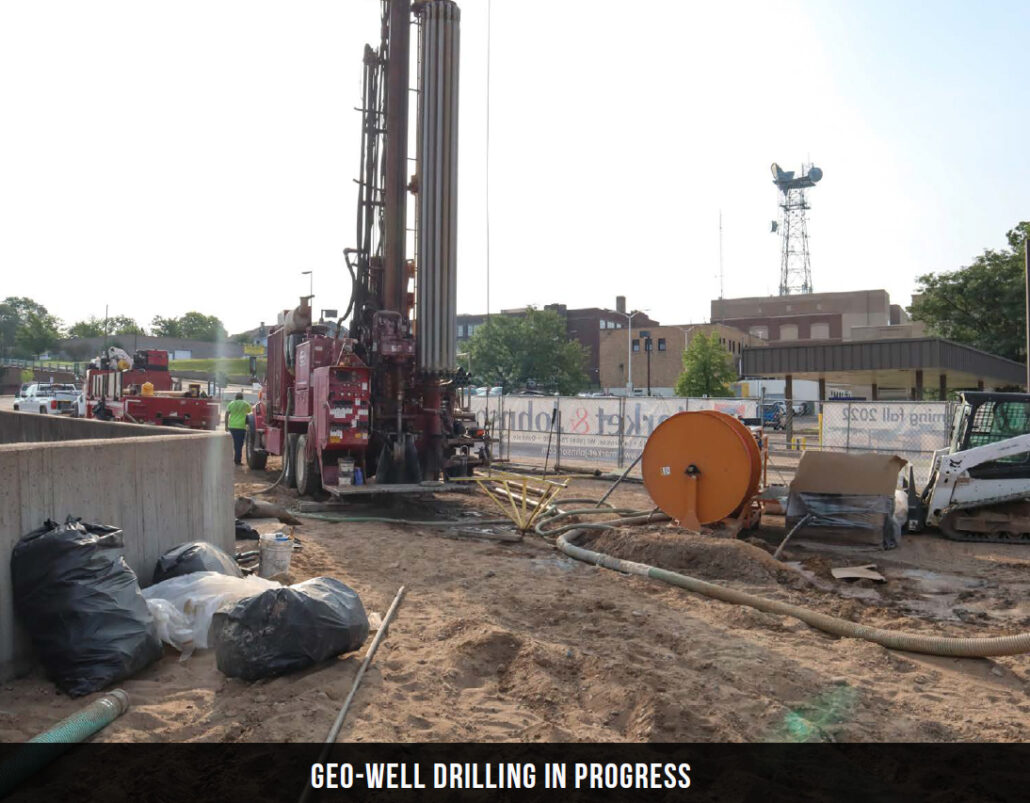

- Began Drilling Geothermal Wells

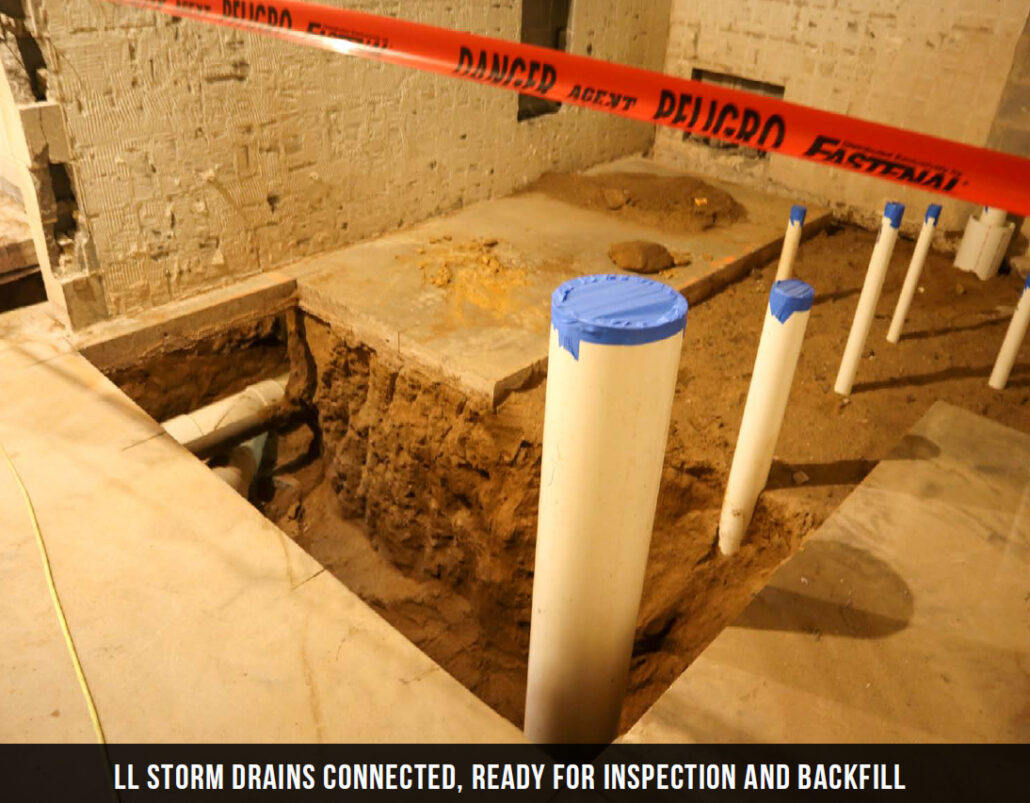

- Began Lower-Level Underground Plumbing
- Began All Trade’s Overhead Rough Ins on 2nd Floor
- Began Framing 1st and 2nd Floor Walls
- Continued to Work Through Shop Drawings and Submittals
Schedule
Structural Steel Install Begins … September 6, 2021
Building Enclosed … December 31, 2021
Install New Elevator … November 15, 2021
Occupancy Inspection … July 1, 2022
Work scheduled for the next 30 days
- Continue Site Work in Eau Claire Street
- Continue Drilling Geothermal Wells

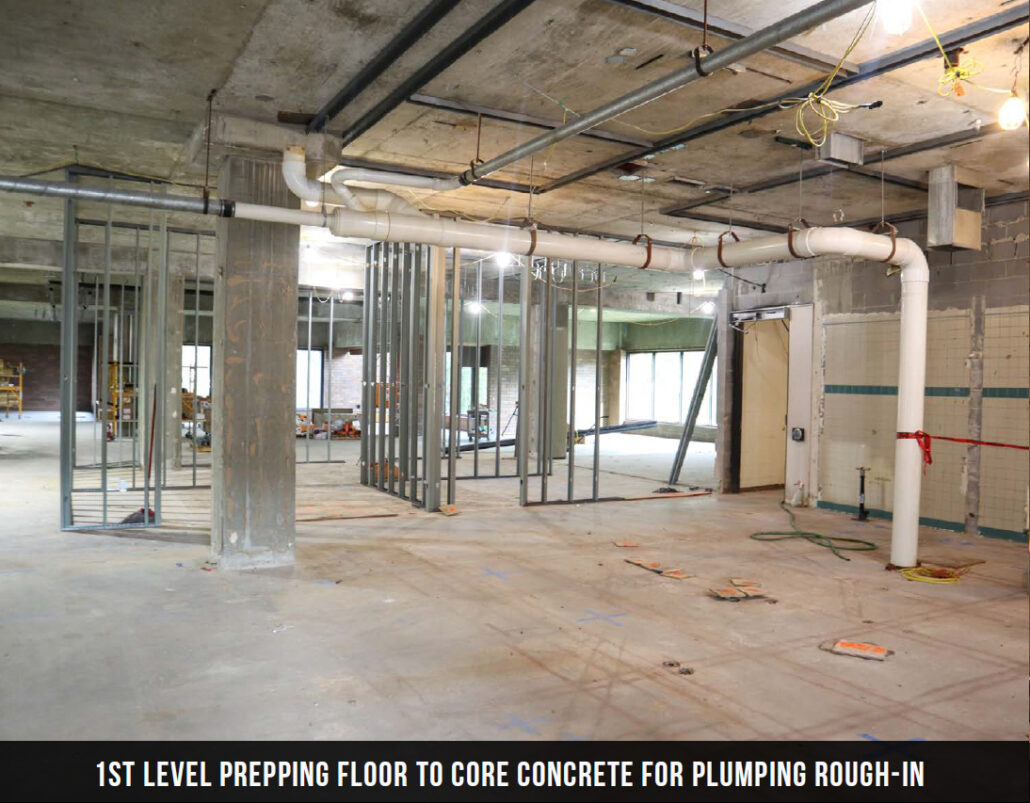

- Complete OH and In-Wall Rough Ins on 2nd Floor
- Complete Framing 2nd Level
- Complete Framing 1st level
- Begin Framing Lower-Level Walls
- Begin All Trade’s Rough Ins on 1st Floor
- Begin All Trade’s Rough Ins on Lower Floor
- Set and Detail Steel and Deck for Roof Addition
- Pour Curbs on Roof
- Core Drilling in 1st and 2nd Bathrooms for Plumbing Fixtures
- Build Back Elevator Pit
- Begin Roofing at Existing Building
- Continue to Work Through Shop Drawings and Submittals
